All Set for Cable Installation at US' First Utility-Scale Wave Energy Test Site

Friday, July 12, 2024

The installation of power and data cables at Oregon State University’s PacWave South, the first pre-permitted, utility-scale, grid-connected wave energy test site in the United States, is set to begin later in July.

The cable installation marks an essential step to completing construction of a new wave energy testing facility off the Oregon Coast.

The work includes installing four power and data cables ranging in length from about 10 to 13 continuous miles from a vault under the parking lot of Driftwood Beach State Park south of Newport out to the test site offshore.

Louisiana-based subsea cable services contractor R.T. Casey is overseeing the installation of the cables.

The work will be carried out by crews aboard three vessels, which is expected to take six to seven weeks, depending on ocean conditions, said Dan Hellin, deputy director of PacWave.

The cables will be anchored in an underground vault at Driftwood and will run through conduits from the shore under the beach, then come up out of the seafloor about one mile out. From there to the test site, the cable will be buried about three feet under the seafloor.

The subsea cables, which were manufactured in Norway by the Paris-based firm Nexans, were transported via freighter to Louisiana and transferred to Offshore Support Vessel (OSV) HOS Innovator, which will be used to lay the cables, to make their way to Oregon.



Once the work begins, a second vessel, the OSV Nautilus, will follow behind to bury the cable using a remotely operated vehicle (ROV). Those two vessels are expected to work around the clock for the duration of the installation and their lights may be visible at night when they are close to shore, Hellin said.

A third vessel, the M/V Liberty, will support diving operations during the cable installation and provide other assistance as needed. That vessel will make trips back and forth from Newport while the work is underway.

On land, another group will be installing cables that run from the vault to a shoreside utility connection and monitoring facility on the east side of Highway 101 just south of Driftwood.

“Transmitting power from wave-energy generators to shore in a form compatible with the regional power grid is a huge challenge, and cabled connection from PacWave South provides the capability to test power-delivery technologies.

“These cables are highly specialized and their installation and burial is a keystone of wave energy development in the U.S,” said Burke Hales, PacWave’s chief scientist and a professor in the OSU College of Earth, Ocean, and Atmospheric Sciences.

When the facility is completed, wave energy developers will be able to test different technologies for harnessing the power of ocean waves and transmitting that energy to the local electrical grid.

The first wave energy developer is expected at PacWave South in 2025 and the first cable-connected test is expected in 2026 under current timelines.

PacWave South is supported by grants from the U.S. Department of Energy, the state of Oregon and other public and private entities. Oregon State’s College of Earth, Ocean, and Atmospheric Sciences is managing the construction and operation of the more than $100 million facility.

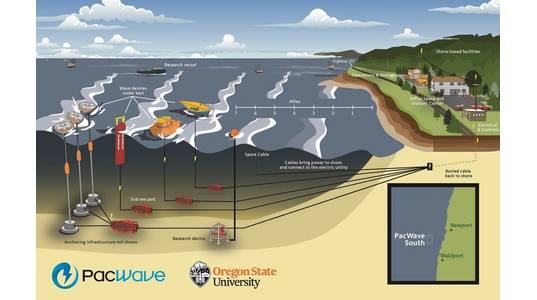

Illustration of proposed PacWave South wave energy testing facility (Credit: Oregon State University)

Categories: Offshore Energy Renewable Energy Subsea Industry News Activity North America Subsea Cables Wave Energy

Related Stories

Inyanga Unveils Tidal Energy Tech Design for 20MW Project in Wales

Prysmian Signs $735M Offshore Wind Connections Deal with French TSO

Argeo Inks Five-Year Offshore Site Investigation Agreement with TotalEnergies

Current News

OE’s 2024 Top of the Festive Video Pops

Offshore Drilling 2025: 3 Things to Watch During a Year of Market Corrections

Chevon’s Sanha Lean Gas Connection Project Achieves First Gas off Angola

BP and Partners Secure Rights for 450MW Offshore Wind Farm in Japan

Subscribe for OE Digital E‑News
